Apulia

Renewables, Nadara: six years to get the OK for an agri-voltaic plant

Nodo autorizzazioni: the bureaucratic process of a project between the Province of Foggia, the Ministry and Palazzo Chigi

by Domenico Palmiotti

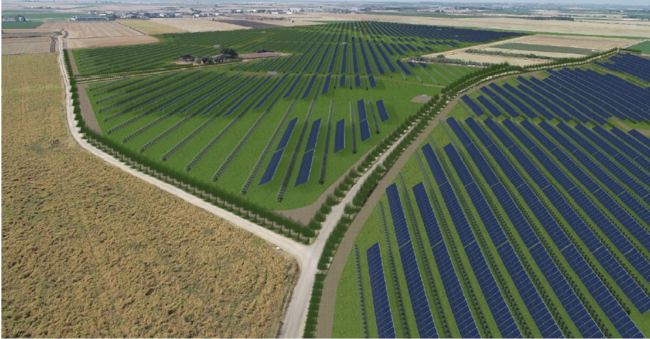

Simulazioni preliminari degli impianti di Nadara in Puglia

2' min read

Translated by AI
Versione italiana

2' min read

Translated by AI
Versione italiana

T he request for authorisation for an investment in agri-voltaics in the Foggia area was submitted in September 2019 to the Province of Foggia and the Apulia Region, but the go-ahead only arrived in August 2025 from the Prime Minister's Office. This is the story of two Nadara projects in the agri-voltaic sector, a 75-million operation involving the Cerro park in San Paolo di Civitate (42 MW of installed power, 75 thousand MWh of annual production of renewable energy to cover the needs of 28 thousand families) and the Mezzanelle park between Apricena and San Paolo di Civitate (47 MW of installed power, 80 thousand MWh of annual production to cover the needs of 30 thousand families).

The authorisation process

"Until 2022, we were not able to conclude the procedure with the Province of Foggia, delegated for the environmental part by the Apulia Region, and so,' explains Gianluca Cipolletta, Nadara's Head of Development Italia, 'we decided to take advantage of the new legislation that had been approved in the meantime, which also allowed photovoltaic plants to go to the Ministry of the Environment to get the OK for construction. At the end of 2022, we thus 'moved' the project from the Province of Foggia to Mase.

Loading...

The latter took just over a year to conclude the environmental authorisation procedure, but when the process was closed in 2023, the Ministry of Culture gave a negative opinion. As there was one ministry in favour and one against, it then went to the Council Presidency to resolve the issue, which took about nine months. Quite quickly compared to other procedures'.

'With the Province of Foggia we also held service conferences, but given the alignment of the timeframe, we went to Mase,' Cipolletta continues. 'For its part, the local authority, like many other public administrations in Italia, complained about a high number of projects to work on and the lack of internal resources.

Comparison with Friuli

"The peculiar thing is that for a similar project in Friuli, which is already in operation, a 33 MW plant, everything was done at regional level and concluded in one year: from June 2022 to June 2023.

We currently have several authorisation processes underway. The regions are moving at different speeds. Sicily has been quite fast in the last few years, in Basilicata we are experiencing some delays, while Mase is gradually bringing up the rear,' Cipolletta adds.

Now, in September, Nadara will launch the first Contractor Open Day in the Foggiano area to involve local companies and present them with the opportunities and benefits of the new investment. The initiative will be announced in Bari over the weekend at the Green Fair. The main contractor is currently being selected from a shortlist of four to five names among Italians and foreigners. Works to start in March 2027, completion in one and a half years.

Copyright reserved ©
